Description

Navigation:  MINUTES >

Description

Previous pageReturn to chapter overviewNext page

The Minutes sheet lists the rows of the WBS in green, interspersed with the Minutes proper in white, which are the items involved in each task. In columns; these Minutes detail the various components of a cost: Material, Workforce, etc.

The opposite structural view is the one of the Expanded WBS. Refer to Description of the WBS. To leave more space for the Minutes, drag the structural view border to the left. To repeat the mark and level of each task within the sheet, insert the columns WBS Item and WBS Level (refer to How to Add Columns).

The Line number column contains the marks of the WBS Item column interspersed with ranks for the Minutes.



The template below shows two Tasks (sections of Minutes) with 3 and 2 Minutes:













MATERIAL

WORKFORCE

Line #

Ref

Description

Unit

Qty

Total cost

Cost per unit

Currency

Total cost

Time per unit

Total Time

Total cost

mark







<



HEADER

ROW









------ >

      < -











COMMENT

ROW









-----  >

1

























2

























3





























Total for task:





















mark







<-



HEADER

ROW









------->

1

























2





























Total for task:























Rows

Each section of Minutes is made up of the following rows:

1.The header which shows the consolidated amounts from the underlying rows. Only the cells shaded in the template above are filled:

       Line number: mark inherited from the Expanded WBS

       Description, Unit and Quantity (those in the WBS); Unit and Quantity can still be edited in the Minutes view

       Currency

       Total Time = Σ Total Times

       MT/Total Cost = Σ Total Cost  x quantity

       WF/Total Cost = Σ Total Cost  x quantity

       Total Cost = Total Cost MT + Total Cost WF (+ Σ Total Cost Time Frame over time).

2.The comments and fictitious chapters inherited from the Expanded WBS (optional, refer to Kinds of Row); by default they are hidden

3.The Minutes (in white) show the material components and their cost, and related human labor (study, mounting, setting, commissioning …); max count: 4096

4.The task bottom line which sums the relevant Minutes amounts (no quantity involved).



VISIBILITY

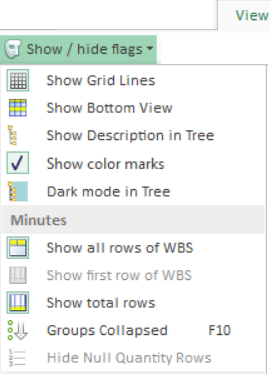

View_flags

When an option is activated, the icon on the left is encircled with a colored hairline.

To show the comments and fictitious chapters, activate the toggler View>Show/hide>Show all rows of WBS.

To hide the first row of WBS, deactivate the toggler View>Show/hide>Show first row of WBS.

To hide the total row, deactivate the toggler View>Show/hide>Show totals.

When the two last togglers are deactivated, there is only one delimiter left, an horizontal hairline between two sections. The line number resets when a new section starts. In addition, you can insert an optional column WBS item or WBS Description.



NOTES

- A section of Minutes can be structured further in sub-sections whose first rows, kind of headlines, usually have only a Line number and a Description in bold typeface and/or underlined (and a Quantity in case of dependency, refer to How to Create Sets of Minutes)

- If values show unexpectedly in the headlines, click View>Show>Check & Repaint WBS.



Columns

All the costs and prices are expressed in the estimate currency selected in the Currencies Sheet, except for the Cost per unit of a material, whose currency is selected in the column Material>Currency. The optional column Workforce>Currency repeats the estimate currency (read-only).

To check out the properties of a native column or the attributes of column with a free field, right click the column and select Properties.

The Minutes default general columns are:

Line number: rank (read-only)

Reference: Part-Number

Description: free text

Unit: free text (packaging of material: reel, tape, bulk ...)

Quantity: count of particular components involved in the assembly or duration (work task); in case of replacement, it can be negative (refer to Bottom Zone)

Total cost: Material Total cost + Workforce Total cost + value of custom columns that are part of the cost (refer to Fields Manager for Minutes and Nomenclatures)

The Material default columns are:

Cost per unit: gross unit cost

Currency

Kind ID: category of material, defined in Set Sheets

Rebate: regular discount (%) on this material (the Rebate Code can be entered in an optional column)

Negotiation: exceptional discount (factor); the base value is defined in Set Sheets; to show it in percent, check the box in File>Options>Settings

Total cost: net cost x quantity.



The Workforce default columns are:

Time per unit: time to carry out 1 piece of work

Time unit: week/hour/minutes, auto-filled after the Kind ID with the unit default value (refer to Set Sheets)

Kind ID: category of required worker or qualification or type of tooling for which a use time can be measured

Efficiency: factor (0.05 thru 5) applied to Time per unit (refer to Set Sheets); to show it in percent, check the box in File>Options>Settings

Total Time: Time per unit x efficiency x quantity

Total cost: Rate (from Overhead) x Total Time.



This is how the Line selling price is calculated through contributions of Material and Workforce (exclusive of roundings):

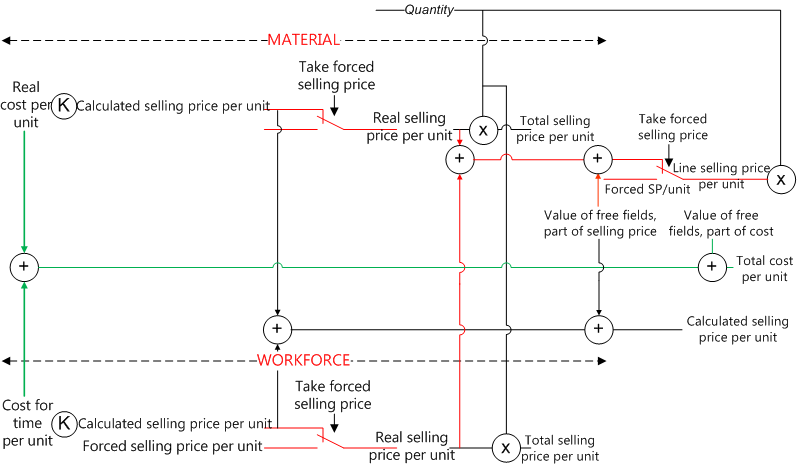

Price chain

NOTES

- For simplicity, we assume the selling mode is Fixed (or Calculated) Factors (K).

- The Material or Workforce set (or any other free set) can be excluded from the selling price calculation. (Refer to Set Sheets.)



OPTIONAL COLUMNS:

Real Cost per unit: Cost per unit x (100 - Rebate) x Negotiation

Time per basic unit: ratio named in the Overhead workbook (Workforce, column D) Number of <common time unit> per unit (time unit of the kind); e.g. 8h per day for a designer

Gross time: Total time

Rate: cost per time unit of the kind

Cost for time per unit: Time per unit x Rate

Cost per unit (general): Total cost (general)/quantity. It includes also the value of free fields belonging to the cost

Public cost (Material): Total cost in the estimate currency

Cost after rebate (Material): Net public cost

Selling Factor: Factor entered in the Overhead workbook

Calculated Selling Price per unit: Selling Factor x Real Cost per unit (Material) or Cost for time per unit (Workforce)

Line Selling price per unit (line = row of minutes): Material selling price + Workforce selling price + value of custom columns that are part of the selling price (Material selling price & Workforce selling price can be undefined in a breakdown of forced prices at WBS level). Refer to Fields Manager for Minutes and Nomenclatures. Exceptions: IDIQ Contracts

Line target value: refer to Target

Line color: mirrors the selection in How to Change the Font, Colors or Layout or receives a numeric entry (refer to How to Fill in the Minutes)

Manufacturer

Family

User field (extra differentiator)

Alter date: Date when the article is inserted from a database

Article date: Latest date when the article was edited in the database

Database path (entered thru How to Create/Edit Articles or How to Record a Set)

Database source (idem)

Supplier

Group header: 1 for the header of a group, 2 for the articles of a group (the digit can be tested using a formula)

Synchronize when unique: set to 1 on the fly to synchronize rows; refer to How to Create Free Columns with Custom Behavior

GUID: Microsoft's Global Unique IDentifier and Has reference in BOQ (refer to Bill of Quantities)

ID for workbook: refer to In-Row Workbooks

Word file: refer to In-Row Documents

WBS Item, Level, Quantity: repetition of WBS columns

WBS_GUID = MergeID

WBS is a (section of) minute (s): 0 for a branch, 1 for a task (header of section), 2 for a Minute

WBS by total: reflects the mode of the parent task

WBS Description: 100 first chars of the task description

WBS HexIndex: 24-bit ID, also visible in the overhead (WBS Sheet)

WBS_LinkParentHexIndex equals

- WBS HexIndex if the heading task is parent of a link as per Links Between Tasks

- WBS HexIndex of the parent for its children

- 0 otherwise

Set depth and Set Visibility: refer to How to Create Sets of Minutes



NOTES

- If a Workforce appears in an explicit manner in the WBS (e.g., the task Studies), only the general and Workforce parts are filled in the Minutes

- A fictitious chapter has a blank value as WBS Item; its item mark shows in the column Line number

- A Minute imported from a database is called an Article



Column coming with the Database of the Estimate

Reference to article

Refer to Database of the Estimate.



Gantt Columns

Refer to Minutes & Tasks.



Free Columns

Depending on the configuration, a sum can be displayed in the bottom line for a custom column:

somme

Refer to How to Create Free Columns with Custom Behavior.



Time Frame Columns

Refer to How to Fill in the Minutes Time Columns.
